Perry Stokes Airport (KTAD)

Airport Development Roadmap
Last Updated September 21, 2026

Development Timeline

Click any project bar to view details

Pinnacle Jet Centers (Private)
Las Animas County
Joint Partnership
Grant Funded
Private Party
βœ“Complete
β—€ Scroll sideways to see more years β–Ά

Airport Vision

Purpose

Further development of the historic Perry Stokes Airport will require a coordinated effort between business stakeholders and public entities. This proposal provides a 10 year development roadmap with key milestones that are needed to create new economic opportunities at and near the airport. The milestones in this report are a mix of private and public development efforts.

Vision

Our vision for Perry Stokes airport is to create opportunity. By reducing the infrastructure, business incentive, and aviation service barriers to growth, we believe development will occur. The milestones established in this report are intended to encourage general, commercial, and military aviation utilization that will benefit our community and fund continued airport growth.

Our goal, at a minimum, is to implement the following improvements by 2035:
  • A full service FBO capable of meeting all aircraft support demands, including overnight hangaring capability
  • Runway access and safety improvements
  • Dedicated helipads and hot refuel points to deconflict rotary and fixed wing traffic
  • Up to 12 privately owned 60x60' (or similar sized) hangars
  • Support to an industrial park focused on advanced manufacturing businesses

By 2035, conditions are set to pursue more advanced aviation opportunities, such as a flight for life base, boutique passenger air service, or vocational flight and maintenance training.

Current Limitations to Growth

The last two years have shown significant growth across General, Business, and Military Aviation segments. However, further growth is limited by a number of infrastructure and service factors:

  • Apron and Traffic Pattern Capacity: Due to a high volume of helicopters using the airport, parking is limited and the traffic pattern is often busy.
  • Overnight Hangar Capacity: No overnight hangar capacity results in reduced overall utilization of the airport by business aviation customers. Aircraft that do visit the airport are less likely to stay overnight due to severe weather risks.
  • Runway Access: No parallel taxiway and no provision for aircraft to turn around on Runway 03 makes access to the runway challenging and potentially hazardous when the airport is busy.

Immediate Airport Infrastructure Needs:

Private Taxilane
Enables Private Hangar Development
Partially Funded β€’ In Progress
βž”
Hot Refuel Point
Increases capacity for air traffic
βž”
RWY 03 "Teacup"
Improves Runway access and safety

Immediate Airport Facility Needs:

Airport Terminal Improvements
Functional and cosmetic updates
Work Underway
βž”
Hangar Share Program
Temp solution for overnight hangaring
βœ“ Complete
βž”
Large Overnight Rental Hangar
Large expected increase in jet traffic

Immediate FBO Service Expansion Needs:

Rental Cars
Enables more overnight stays
βœ“ Complete
βž”
Lav, GPU, Tug, O2, and De-ice
Improved services for large aircraft
βž”
Full Service AVGAS Truck
Improves offerings for Piston aircraft

Airport Operations Data

Civilian Jet & Helicopter Operations: A Growth Story

Civilian jet and helicopter operations have grown dramaticallyβ€”from just 80 operations in all of 2024 to 289 in 2025, a 261% increase. Through September, 2026 has already recorded 412 operations, surpassing all of 2025. With the airport rental car fleet and hangar share program now in place, we expect this trajectory to continue.

2024 Civilian Jets & Helos

2024 Civilian Jet and Helicopter Operations

80 total operations (40 takeoffs, 40 landings)

Click to enlarge

2025 Civilian Jets & Helos

2025 Civilian Jet and Helicopter Operations

289 total operations (122 takeoffs, 111 landings)

Click to enlarge

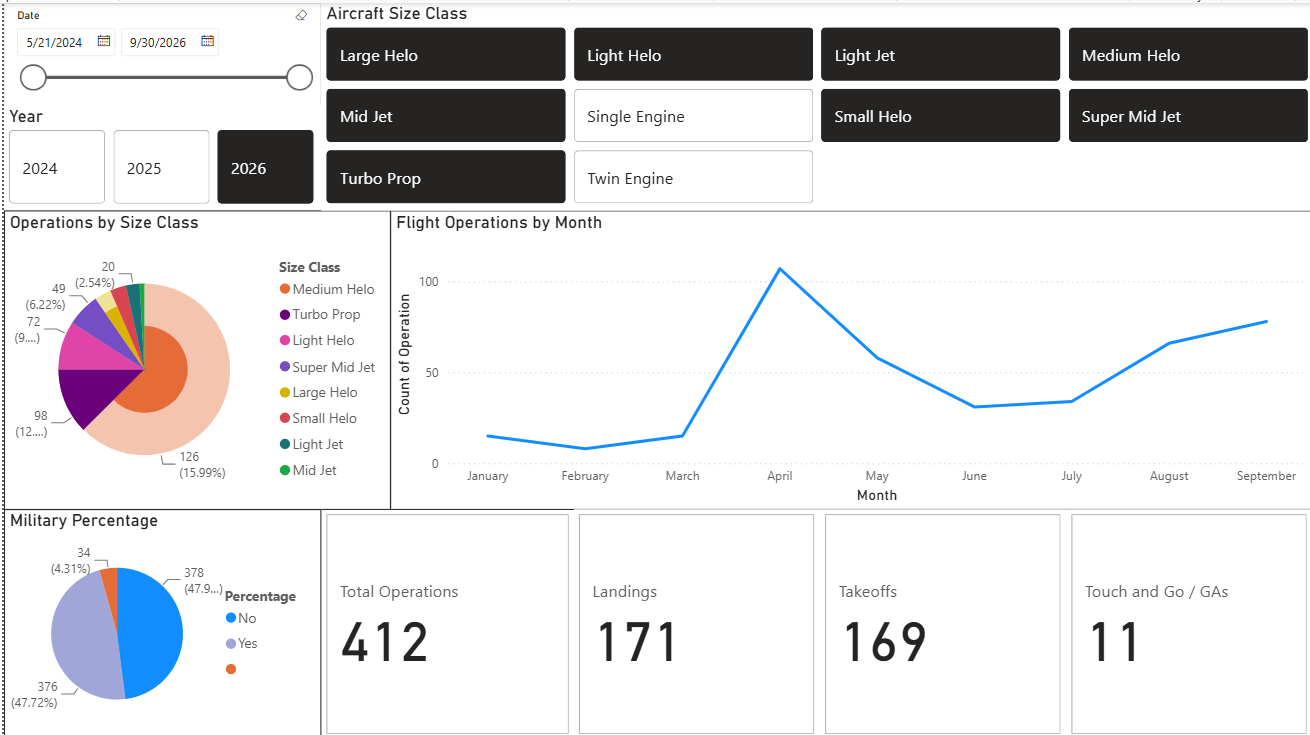

2026 Civilian Jets & Helos (Year to Date)

2026 Civilian Jet and Helicopter Operations, year to date

412 recorded operations (171 landings, 169 takeoffs, 11 touch-and-go)

Click to enlarge

Military Operations

Perry Stokes Airport serves as a key refueling and training location for Army rotary-wing units. The charts below show military reservation and mission data. After the anticipated slow period during Fort Carson's deployment, Fort Carson aircraft are returning to the PiΓ±on Canyon Maneuver Site (PCMS) and KTAD in growing numbers. Military sales are expected to gradually return to 2025 levels over the next three months, with full training volumes resuming in February and March 2027.

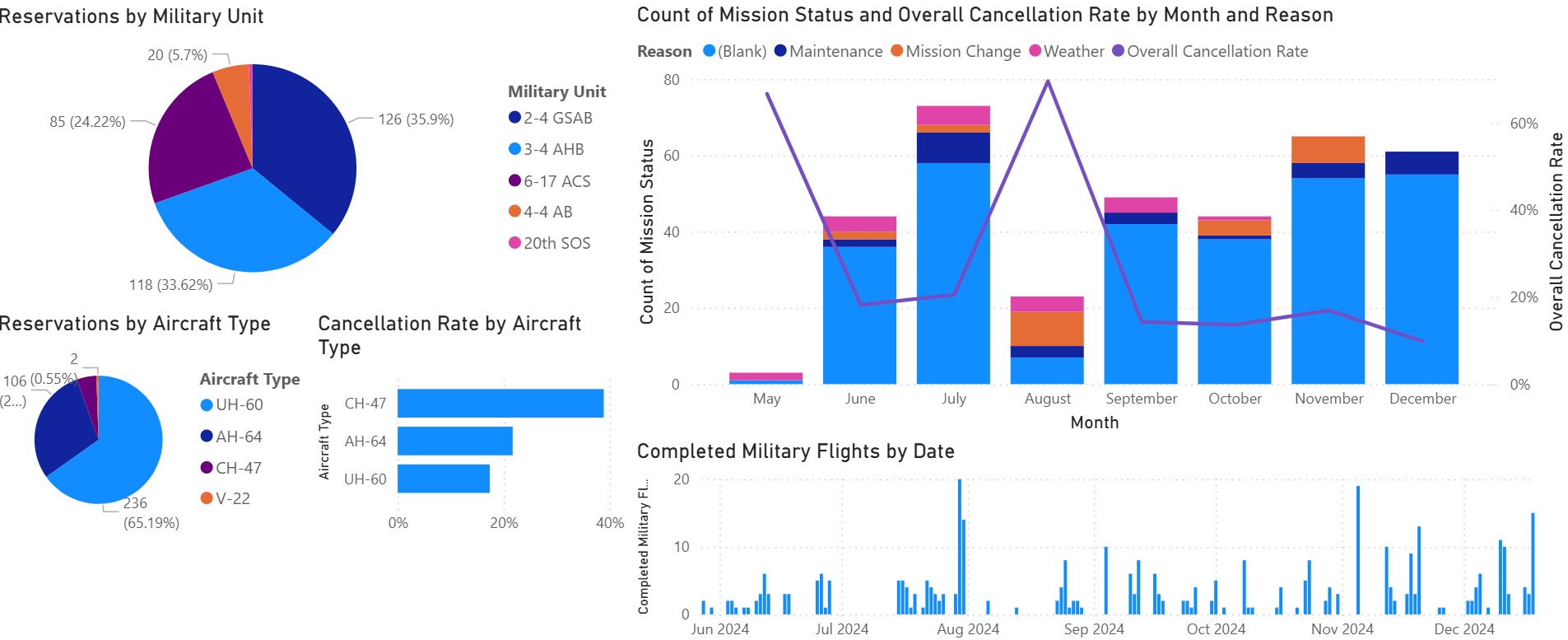

2024 Military Operations

2024 Military Operations

Click to enlarge

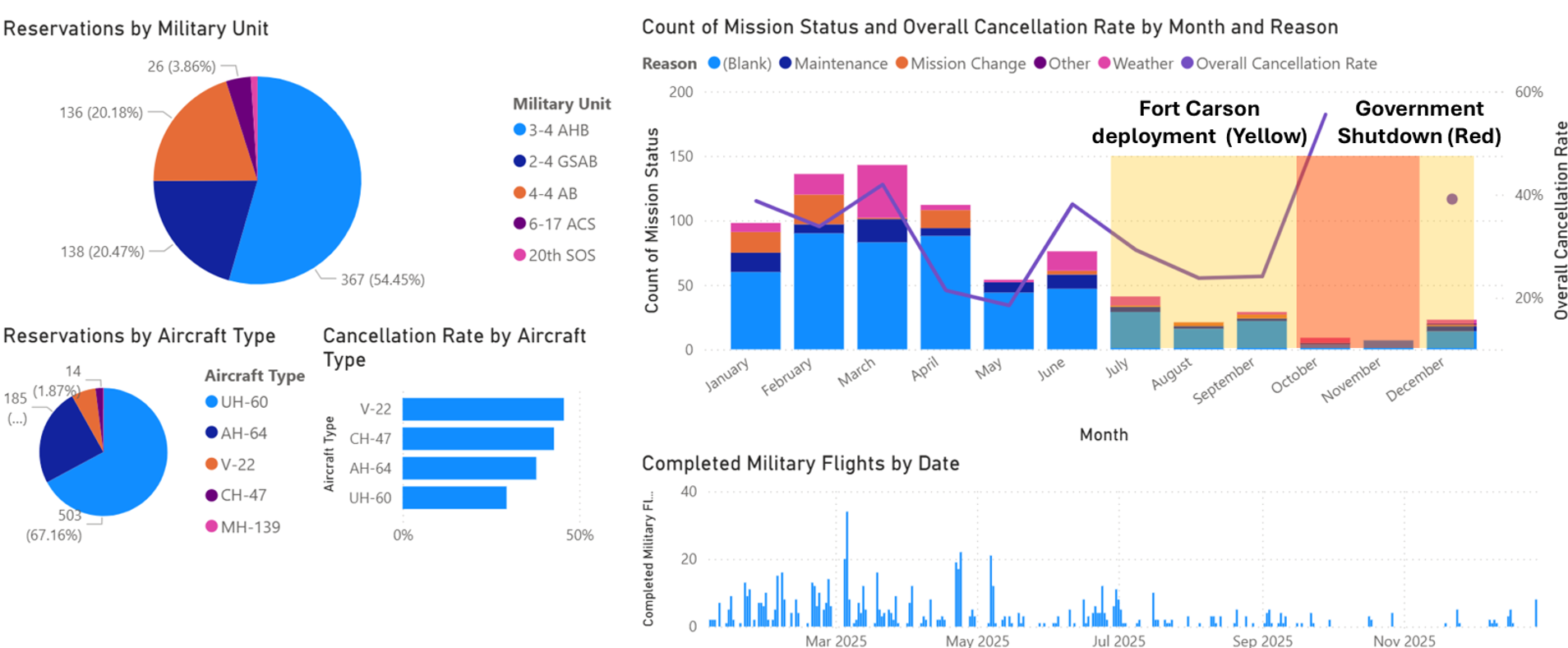

2025 Military Operations

2025 Military Operations

Click to enlarge

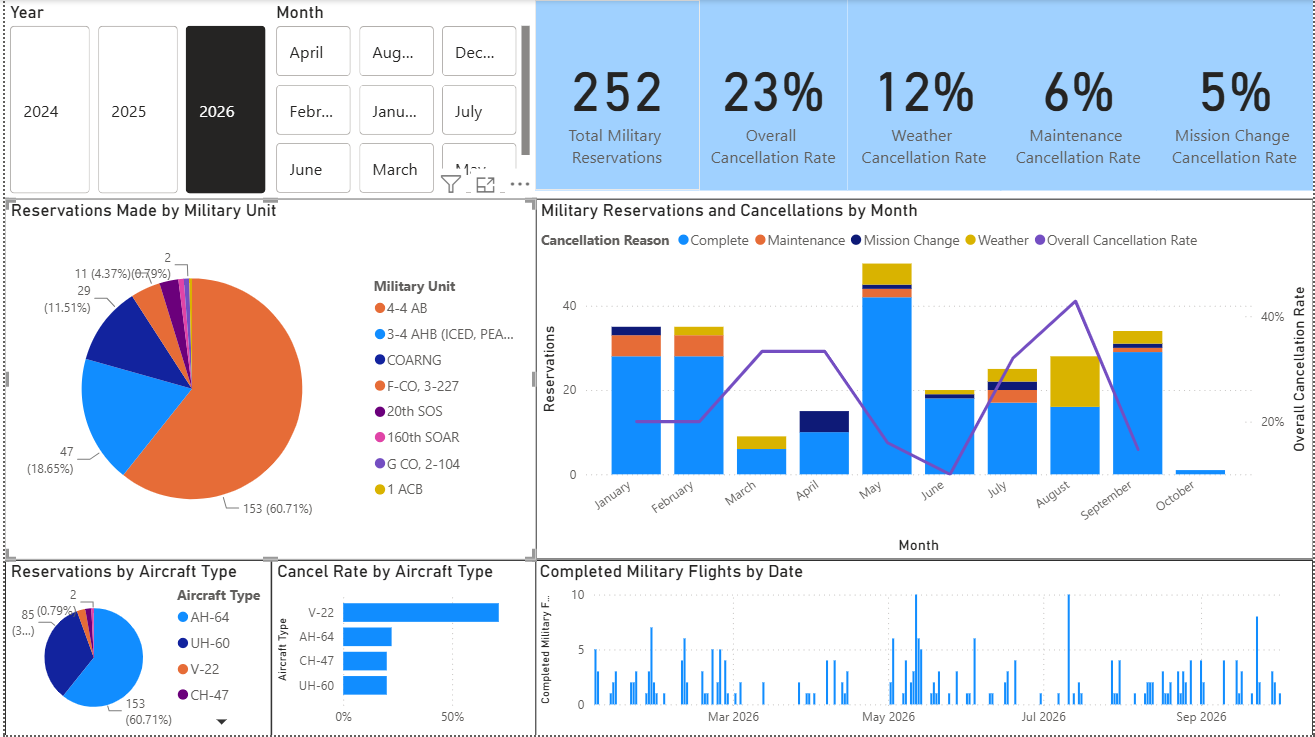

2026 Military Reservations (Year to Date)

2026 Military Reservations, year to date

Click to enlarge

Total Airport Operations

The loss of the CAE flight school in Pueblo resulted in a 35-40% reduction in total operations throughout 2026. While this may seem troubling, it is important to remember that CAE traffic was non-revenue generating: high operation counts, but extremely low fuel volumes and minimal local economic impact. Our revenue-generating customers have continued to grow with improvements to services and facilities at the airport.

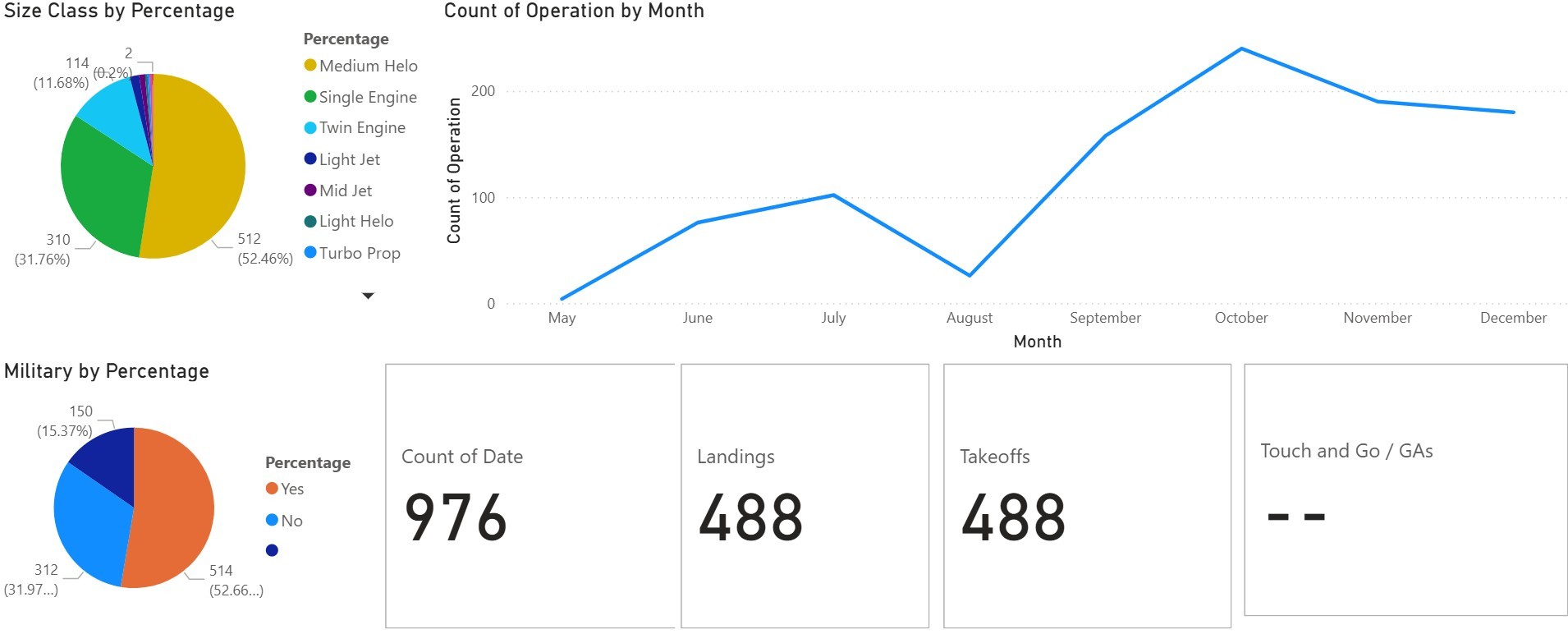

2024 Total Operations

2024 Total Airport Operations

976 operations (488 landings, 488 takeoffs)

Click to enlarge

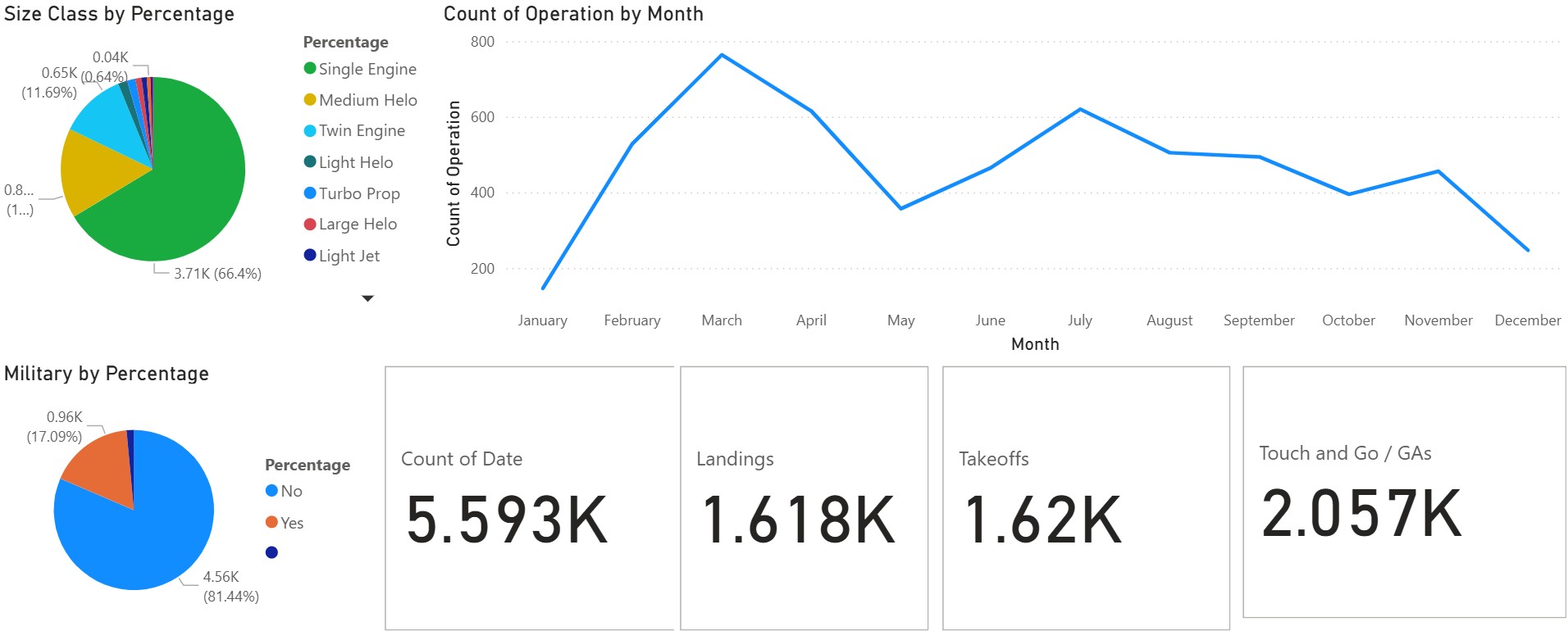

2025 Total Operations

2025 Total Airport Operations

5,593 operations (1,618 landings, 1,620 takeoffs, 2,057 touch-and-go)

Click to enlarge

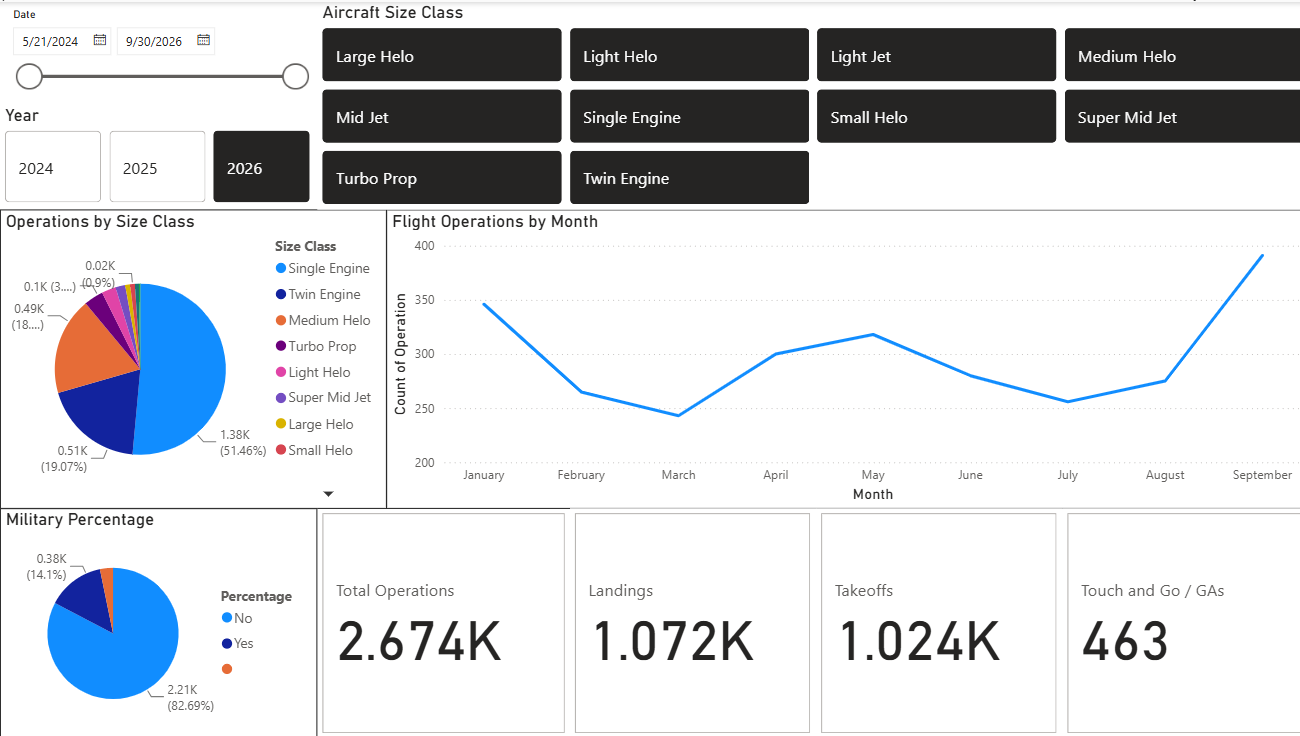

2026 Total Operations (Year to Date)

2026 Total Airport Operations, year to date

2,674 operations (1,072 landings, 1,024 takeoffs, 463 touch-and-go/go-arounds)

Click to enlarge

Key Takeaway: While total operations fluctuate with military cycles and flight school activity, the operations that matter most for local economic impact are growing rapidly.

Airport Growth Targets

Hangars and Parking

Hangars and Parking 2025 (Actual) 2030 (Projected) 2035 (Target)
T-Hangars 22 22 22
Privately Owned Hangars 1 4 6-12
Overnight Hangar Parking Capacity 0 3 3
Jet Parking Spots (Hangar+Outdoor) 4 10 10

Annual Operations

Annual Operations 2025 (Actual) 2030 (Projected) 2035 (Target)
Passenger Enplanements Est 624 Est 936 Est 1,344
Business Aviation Operations (Jets+Multi Engine) 886 (156 jets) 1,146 (234 jets) 1,248 (336 jets)
Military Aviation Operations (Helicopters) 668 835 800
General Aviation Operations (Single Engine) 7,582 9,098 12,100

Fuel Flowage

Fuel Flowage 2025 (Actual) 2030 (Projected) 2035 (Target)
Business Aviation Fuel Sales (Jet-A) 12,376 gal 24,752 gal 67,200 gal
Military Aviation Fuel Sales (Jet-A) 155,334 gal 240,000 gal 300,000 gal
General Aviation Fuel Sales (AVGAS) 31,364 gal 37,636 gal 45,000 gal

Annual Revenues Generated

Annual Revenues Generated 2025 (Actual) 2030 (Projected) 2035 (Target)
Flowage Fees paid to LAC $0 $15,119 $20,610
Ground Leases paid to LAC $1,351 $6,302 $11,304
Sales Taxes Paid $8,848 $15,718 $18,136
Fuel Excise Taxes (Fed and State) $12,378 $14,480 $27,994
Payroll Taxes (employee and employer) $37,796 $52,914 $75,592
Total Fed, State, and Local Revenue $60,373 $104,533 $153,636

Economic Impacts

Economic Impacts 2025 (Actual) 2030 (Projected) 2035 (Target)
Direct Employment 5 7 10
Indirect Employment (CEIS Airport Study) Est 35 Est 49 Est 70
FBO Local Spend (includes Payroll) $254,888 $318,610 $509,776
Estimated Direct Impact to Tourism
(estimated $640 per enplaned passenger)
Est $399,360 Est $599,040 Est $860,160

Proposed Airport Fee Schedule

Airport Owned Hangar Monthly Rental

Airport Owned Hangar Monthly Rental Current 2030 2035
T-Hangar
Current rate begins 2027
$175/mo legacy tenants
$250/mo new tenants
$250/mo $325/mo
End Storage Unit, Medium $100/mo $116/mo $135/mo
End Storage Unit, Large $125/mo $145/mo $170/mo

Ground Lease Rates (On New Leases)

Ground Lease Fee Rate
Ground Lease Rate (all lot sizes) $0.20/sf per year
Initial Application Fee $3,500 (one time)
Ground Lease Notes:
  • Escalation: Rates increase $0.03 per square foot every 5 years. Lessees pay a fixed rate for each 5-year period ($0.20, $0.23, $0.26, $0.29, and $0.32/sf over a 25-year term).
  • Lot Size Requirements: Lease rates apply to the entire lot size. Minimum setbacks: 15 feet from taxilane, 10 feet from side and rear lot lines. Septic systems must be at least 10 feet from all lot boundaries.
  • Lease Terms: Standard 25-year lease with two 10-year renewal options (45 years maximum).

Example Ground Lease Calculations

The following examples illustrate annual lease payments over a 25-year lease term at $0.20/sf, increasing $0.03/sf every 5 years:

Example Hangar Years 1-5
$0.20/sf
Years 6-10
$0.23/sf
Years 11-15
$0.26/sf
Years 16-20
$0.29/sf
Years 21-25
$0.32/sf
60' Γ— 60' Hangar with Septic
7,350 sf lot
$1,470/yr
$123/mo
$1,691/yr
$141/mo
$1,911/yr
$159/mo
$2,132/yr
$178/mo
$2,352/yr
$196/mo
90' Γ— 120' Hangar with Septic
18,900 sf lot
$3,780/yr
$315/mo
$4,347/yr
$362/mo
$4,914/yr
$410/mo
$5,481/yr
$457/mo
$6,048/yr
$504/mo

Fuel Flowage Fees

Fuel flowage fees to Las Animas County are $0.05 per gallon. Projected fees at forecasted fuel volumes:

Year Projected Fuel Flow Flowage Fee Rate Flowage Fees to LAC
2027 150,000 gallons $0.05/gallon $7,500
2028 175,000 gallons $0.05/gallon $8,750
2029 200,000 gallons $0.05/gallon $10,000

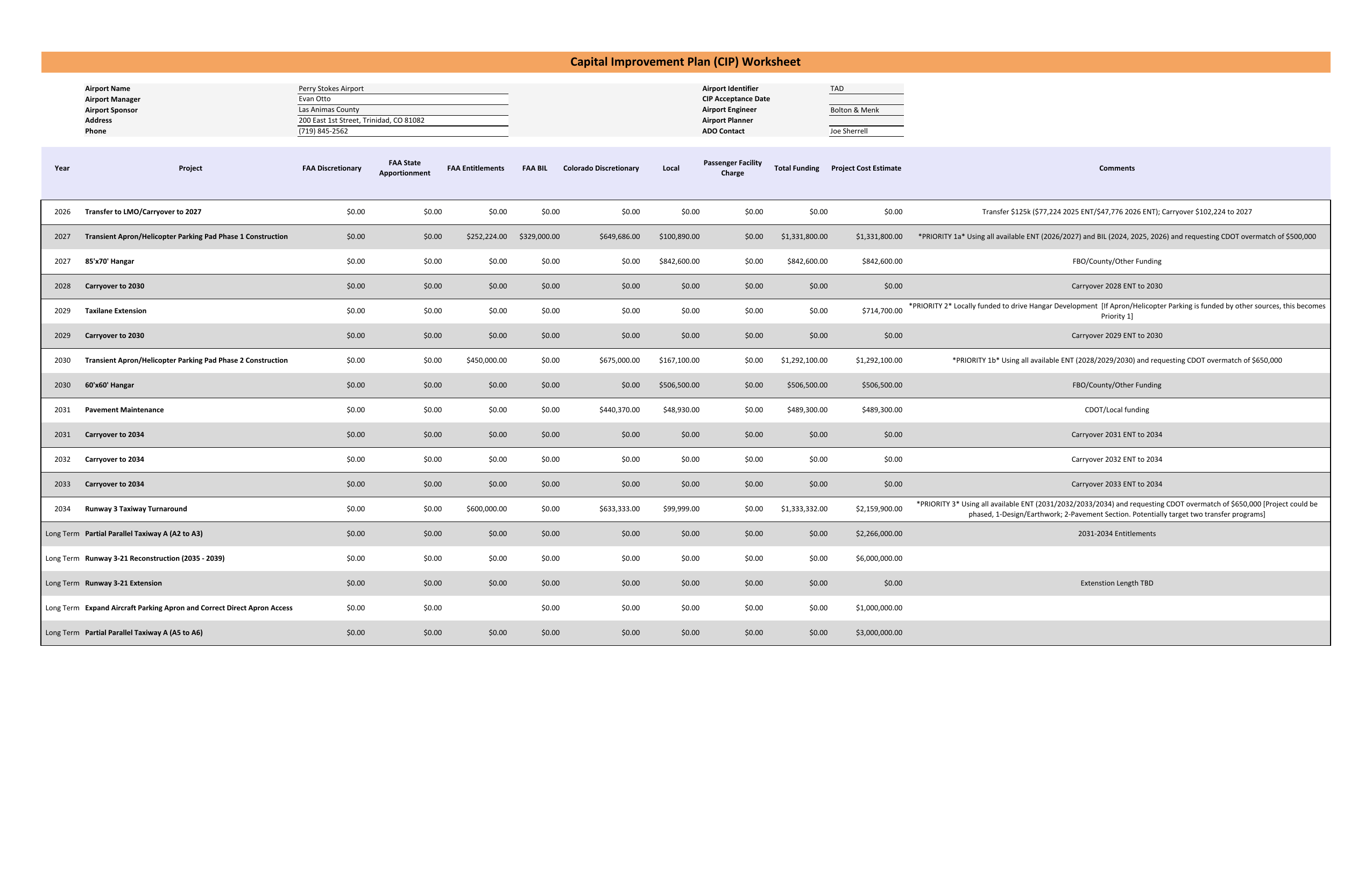

Capital Improvement Plan (CIP) FY 2026-2035

The CIP represents the programmed infrastructure investments for Perry Stokes Airport, coordinated between Las Animas County and the FAA. This 10-year plan identifies funded projects, funding sources, and long-term priorities necessary to support airport growth.

AirportPerry Stokes Airport (TAD)
SponsorLas Animas County
CIP Acceptance Date12/31/2025
ADO ContactJoseph Sherrell
YearProjectFAA DiscretionaryFAA State ApportionmentFAA EntitlementsColorado DiscretionaryLocalPassenger Facility ChargeTotal FundingProject Cost EstimateComments
2026Carryover to 2030β€”β€”β€”β€”β€”β€”β€”β€”
2027Transfer to Pagosa Springsβ€”β€”β€”β€”β€”β€”β€”β€”
BIL Allocation - Transient Apron/Helicopter Parking Pad Phase 1 Constructionβ€”β€”$439,000$11,552$11,553β€”$462,105$1,292,100*PRIORITY 1B* Using all available ENT (2028/2029/2030 and requesting CDOT overmatch of $500,000
Overmatch Transient Apron/Helicopter Parking Pad Phase 1 Constructionβ€”β€”β€”$500,000$55,556β€”$555,556$1,292,100*PRIORITY 1B* Using all available ENT (2028/2029/2030 and requesting CDOT overmatch of $500,000
Transient Apron/Helicopter Parking Pad Phase 1 Constructionβ€”β€”$102,224$2,690$2,691β€”$107,605$1,292,100*PRIORITY 1B* Using all available ENT (2028/2029/2030 and requesting CDOT overmatch of $500,000
2028Transfer to Salidaβ€”β€”β€”β€”β€”β€”β€”β€”
2029Transfer to Sterlingβ€”β€”β€”β€”β€”β€”β€”β€”
Taxi Lane Extensionβ€”β€”β€”β€”β€”β€”β€”$714,700*PRIORITY 2* Locally funded to drive Hangar Development (if Apron/Helicopter Parking is funded by other sources, this becomes Priority 1.
2030Transient Apron/Helicopter Parking Pad Phase 2 Constructionβ€”β€”$600,000$33,333$33,334β€”$666,667$1,292,100Transfers from Pagosa Springs, Salida, and Sterling.
60x60 Hangarβ€”β€”β€”β€”$506,500β€”$506,500$506,500FBO/County/Other Funding
Overmatch Transient Apron/Helicopter Parking Pad Phase 2 Constructionβ€”β€”β€”$650,000$72,222β€”$722,222$1,292,100*PRIORITY 1B* Using all available ENT (2028/2029/2030 and requesting CDOT overmatch of $650,000
2031Pavement Maintenanceβ€”β€”β€”β€”$48,930β€”$48,930$489,300CDOT /Local Funding Request CDOT Funding $440,370.00
Transfer to Steamboat Springsβ€”β€”β€”β€”β€”β€”β€”β€”Carryover 2031 to 2034
2032Transfer to Sterlingβ€”β€”β€”β€”β€”β€”β€”β€”Carryover 2032 ENT to 2034
2033Transfer to Buena Vistaβ€”β€”β€”β€”β€”β€”β€”β€”Carryover 2033 ENT to 2034
2034Runway 3 Taxiway Turnaround Ph 1β€”β€”$600,000β€”$99,999β€”$699,999$2,159,900*PRIORITY 3* Using all available ENT (2031/ 2032/ 2033/ 2034 transfers from SBS, STK and AEJ) and requesting CDOT overmatch of $650,000 (Project could be phased, 1-Design/Earthwork; 2-Pavement Section. Potentially target two transfer programs)
2035Runway 3 Taxiway Turnaround Ph 2β€”$600,000$600,000$666,666$666,667β€”$2,533,333$2,159,900*PRIORITY 3* Using all available ENT (2035/36/37/38 transfers from? ? and ?) and requesting CDOT overmatch of $650,000 (Project could be phased, 1-Design/Earthwork; 2-Pavement Section. Potentially target two transfer programs)
Long TermPartial Parallel Taxiway A (A2 to A3)β€”$4,000,000β€”β€”β€”β€”$4,000,000$2,266,0002031 - 2034 Entitlements
Runway 3-21 Reconstruction 2035-2039β€”β€”β€”β€”β€”β€”β€”$6,000,000
Runway 3-21 Extensionβ€”β€”β€”β€”β€”β€”β€”β€”Extension Length TBD
Expand Aircraft Parking Apron and Correct Direct Apron Accessβ€”β€”β€”β€”β€”β€”β€”$1,000,000
Partial Parallel Taxiway A (A5 to A6)β€”β€”β€”β€”β€”β€”β€”$3,000,000

Source: FAA WIMS CIP Worksheet. Dashes indicate $0 or no amount entered.

Unmet Funding Requirements

The following projects represent immediate priorities that currently lack secured funding. These investments are critical to supporting airport growth and military readiness.

Project Purpose Estimated Cost Available Funding & Source Funding Needed Status
Taxilane Extension Opens 6 new affordable ground lease spots for private hangar construction. Phase 1 (2026) opens the first two hangar lots. $366,388
Full build-out estimate
~$101,000
County: Asphalt $50k (contracted) + In-Kind Base Work $35k + CatEX ~$16k (paid)
~$265,388 Applying for Energy Impact Grants to Fund in 2027
Terminal MEP & Windows Historic terminal climate control upgrades, electrical panel upgrades to remove safety and power availability hazards, new period-appropriate energy-efficient windows, roof membrane replacement, and a commercial water heater upgrade $257,660
ATP grant application estimate
β€” $257,660 No Grant Source Identified
ATP grant not funded

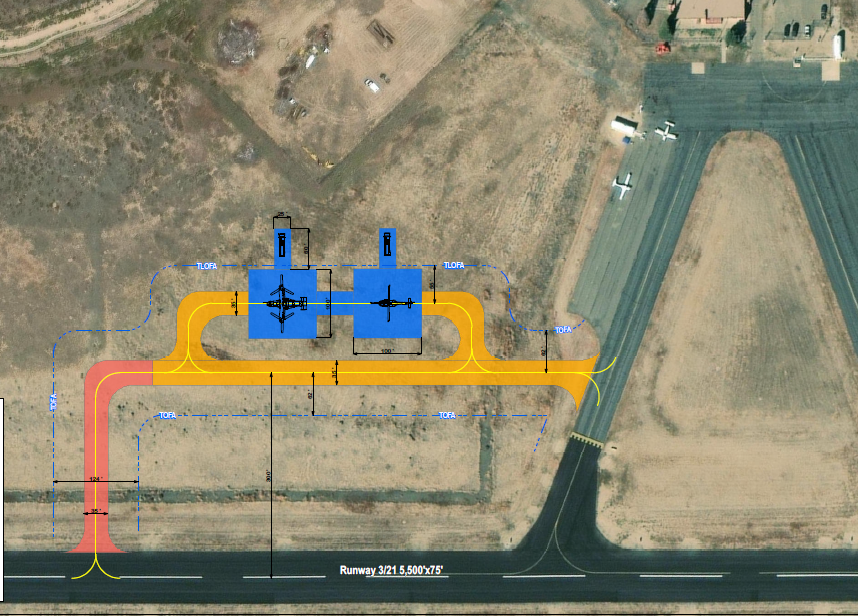

Hot Refuel Pads Hot Refuel area to separate helicopter and plane traffic while increasing overall airport capacity $2,466,845 β€”
PJC up to $50k committed if CPF/CDS funding is approved
$2,466,845 Awaiting Results of 2027 CPF and CDS Funding

Airport Layout Plan (ALP)

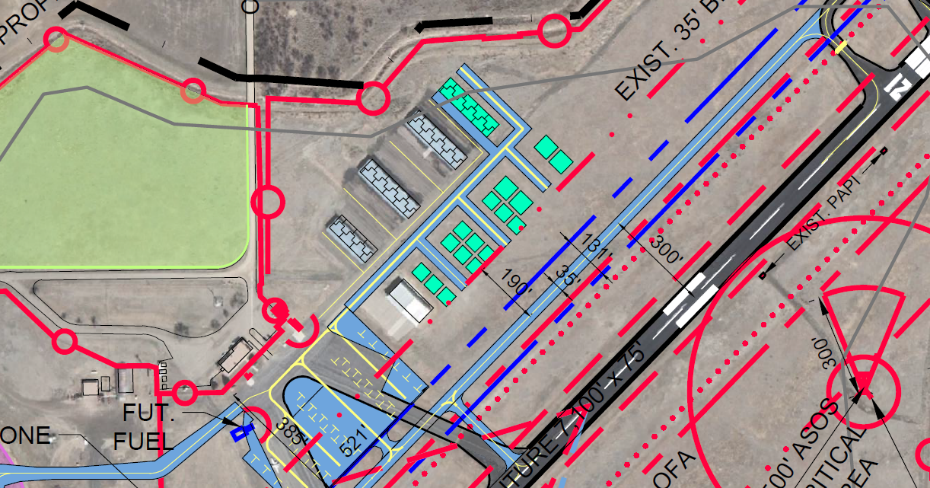

The proposed Airport Layout Plan shows the planned development areas, runway safety zones, and future infrastructure projects. This plan guides all airport development and must be approved by the FAA for any federally-funded improvements.

Perry Stokes Airport Layout Plan - FY 2026-2035 CIP Overview

Click image to enlarge

Key Development Areas Shown:

  • 2027: Transient Apron/Helicopter Parking Pad Phase 1
  • 2029: Taxilane Extension, 60'x60' Hangar Construction
  • 2030: Transient Apron/Helicopter Parking Pad Phase 2
  • 2031: Pavement Maintenance
  • 2034: Runway 3 Taxiway Turnaround
  • Future: Partial Parallel Taxiways, Runway Extension, Apron Expansion

2025 Colorado Aviation Economic Impact Study

The Colorado Department of Transportation (CDOT) Division of Aeronautics conducted the 2025 Colorado Aviation Economic Impact Study to understand how Perry Stokes Airport (TAD) supports economic activity. The study found that TAD generated $2.5 million in total business revenues, supporting 14 jobs and $770,000 in payroll in 2023.

πŸ“„ Open PDF in New Tab
Project Details

2025 Projects

Bathroom Renovation

2025 β€’ In Progress
Purpose
Modernize the historic terminal's bathroom facilities to meet ADA compliance and support overnight aircraft crews.
Project Description
Complete demolition of both existing bathrooms, replacement of all electrical and plumbing fixtures to align with new septic lines, and rough-in of one shower with new electrical throughout. The finished bathrooms will feature high-end tile and brushed stainless fixtures to create an elegant, comfortable facility capable of supporting aircrews staying overnight. All work meets ADA compliance requirements including installation of a water fountain.
Who Pays
Pinnacle Jet Centers (Private Investment)
Timeline
Bath 1 Complete by Jan 2026 β€’ Bath 2 Complete by June 2026
Total Investment
$40,288
← Timeline

Storage Unit Buildout

2025 β€’ In Progress
Purpose
Maximize use of existing rentable spaces by converting end units to vehicle and equipment storage.
Project Description
Replace garage doors on three hangar buildings and produce long-term storage agreements with a multi-year fee structure. Converting these underutilized spaces creates additional revenue while providing valuable covered storage options for airport tenants and community members.
Who Pays
Pinnacle Jet Centers (Private Investment)
Timeline
Doors installed Dec 2025 β€’ New leases in 2026
Total Investment
$5,000
← Timeline

Septic System

2025 β€’ Complete
Purpose
Replace aging septic infrastructure to support terminal improvements and future development.
Project Description
This critical infrastructure upgrade ensures the terminal can accommodate increased usage from growing airport traffic and sets the foundation for bathroom renovations and other facility improvements.
Who Pays
Las Animas County
Timeline
Complete
Total Investment
County Funded
← Timeline

Hangar Share Program

2025 β€’ Complete
Purpose
Creative solution to provide transient jet hangaring using existing privately owned hangar space through business partnership.
Project Description
In the absence of a dedicated transient rental hangar, PJC established a business partnership with hangar owners to create an accessible reservation system, ensuring service availability for transient private jets. This interim solution addresses a critical gap in airport services until larger hangar facilities can be constructed.
Who Pays
Pinnacle Jet Centers (Operational)
Timeline
Complete December 2025
Total Investment
$0 (Partnership)
← Timeline
← Back to Timeline

2026 Projects

Apron & Teacup Crack Repairs

Spring 2026
Purpose
Fill major cracks on airport surfaces prior to seal coat project. Uses CDOT statewide programs for materials.
Project Description
Apply mastic to major cracks along Taxiway A3, A4, and the Runway 21 teacup which are severe and must be addressed before seal coating can be effective. PJC will pick up the mastic machine from Colorado Springs (KCFO) and apply approximately 40 hours of labor to fill large cracks across the airport.
Who Pays
CDOT (90% materials) β€’ County (~$1,000) β€’ PJC (~$1,330 labor)
Timeline
Spring 2026 (before seal coat)
Total Project Cost
~$10,000 (mostly CDOT)
← Timeline

Airport Seal Coat

Spring 2026
Purpose
CDOT-funded maintenance to prolong current asphalt lifespan on runways and taxiways.
Project Description
This preventative maintenance treatment protects pavement from weather damage and extends the usable life of airport surfaces, deferring the need for more costly reconstruction. The crack repair project must be completed before seal coating can begin.
Who Pays
CDOT Division of Aeronautics β€’ County coordination
Timeline
March 2026 (estimated)
Total Investment
CDOT Funded
← Timeline

Private Hangar Taxilane

2026
Purpose
Build taxilane to provide access to 6 potential ground lease plots for private hangar development. Creates new County revenue stream.
Project Description
This project unlocks significant private investment potential by enabling aircraft owners to build their own hangars on County-leased land. Road and Bridge will source and place necessary base aggregate, while the County will contract asphalt work. An environmental assessment (NEPA) is required before construction can begin.
Who Pays
Las Animas County (Road & Bridge + contracted asphalt)
Potential Revenue
$10,800/year in ground lease fees to County
Timeline
2026 (Environmental assessment + construction)
Total Investment
TBD
← Timeline

Rental Car Service

Spring 2026
Purpose
Partner with nationally recognized rental car company to address major limitation of ground transportation availability.
Project Description
The current courtesy car is insufficient to meet peak demand during spring and fall, resulting in lost flight reservations. PJC will partner with a nationally recognized rental car company to provide flight crews with reliable rental cars during all seasons. This service addition removes a significant barrier to airport utilization and supports increased business aviation traffic.
Who Pays
Pinnacle Jet Centers (Operational Partnership)
Timeline
Agreement in progress β€’ Launch Spring 2026
Total Investment
$0 (Partnership)
← Timeline

New Radio Frequency (CTAF)

Spring 2026
Purpose
Safety improvementβ€”all nearby airports share the same frequency, causing confusion. New dedicated frequency reduces pilot confusion.
Project Description
Currently, all nearby airports use the same Common Traffic Advisory Frequency (CTAF), resulting in radio transmissions from pilots at other airports cluttering Perry Stokes communications. A dedicated frequency will reduce confusion for pilots operating at Perry Stokes, particularly student pilots and those unfamiliar with the area. PJC will request the new frequency from the FCC and coordinate publication changes with the FAA.
Who Pays
Pinnacle Jet Centers
Timeline
FCC application Jan 2026 β€’ 30-90 days for approval
Total Investment
Administrative Only
← Timeline

Terminal Renovation

2026-2027
Purpose
Modernize airport terminal while preserving historic character. Includes cosmetic improvements, mechanical/electrical upgrades, and energy efficiency improvements.
Project Description
Phase 1 (PJC-funded) includes refinishing historic wood wainscot, repairing trim throughout, painting interior spaces, renovating the pilot lounge, building an aircrew overnight room, and exterior improvements including pergola replacement and fixture repairs. Phase 2 (grant-dependent) includes installation of a 6-zone cold-climate mini-split system, replacing the 1950s boiler with a high-efficiency unit, modernizing electrical panels, installing a commercial water heater, and replacing 33 single-pane windows with energy-efficient period-appropriate units.
Who Pays
If ATP Grant Awarded: PJC $38,244 + Federal $194,642
If Not Awarded: PJC $48,000
Timeline
Cosmetics: Summer 2026 β€’ MEP (if grant): May-Sept 2027
Total Project Cost
$204,886 - $232,886
← Timeline

Airport Minimum Standards

Fall 2026
Purpose
Establish standardized requirements for commercial entities (insurance, operating standards) to ensure all businesses meet County vision for airport development.
Project Description
Growing aeronautical use creates opportunities for commercial leasing at the airport. Commercial Minimum Standards create a standardized list of requirements for all commercial entities, including insurance requirements, business operating standards, and facility maintenance expectations. Las Animas County, advised by their engineer of record and the FBO, will approve standards covering all commercial and private aeronautical users as well as non-aeronautical users in the planned industrial park.
Who Pays
Pinnacle Jet Centers (50%) β€’ Las Animas County (50%)
Timeline
Fall 2026
Total Investment
TBD (shared 50/50)
← Timeline

90th Anniversary Fly-In & Community Event

August 2026
Purpose
Celebrate Perry Stokes Airport's 90th anniversary. Generate local interest in aviation and showcase airport improvements to community and visiting aviators.
Project Description
The two-day event includes a Fly-In open to aviators (free overnight parking, fuel sold at cost, shuttle service to town) and a Community Day open to the public. Community Day will showcase airport improvements with military helicopter static displays from Fort Carson, corporate jet displays, aviation career booths, and discovery flights for interested community members. This event introduces the community to aviation career opportunities while demonstrating the airport's growth to regional aviators.
Features
Military helicopter static displays β€’ Corporate jet displays β€’ Aviation career booths β€’ Discovery flights β€’ Food vendors β€’ Shuttle service
Who Leads
Pinnacle Jet Centers β€’ Trinidad Downtown Association β€’ Las Animas County
Timeline
August 29-30, 2026
Expected Attendance
Up to 800 people
← Timeline

90th Anniversary Event Layout

90th Anniversary Fly-In Event Layout
← Back to Timeline

2027 Projects

Establish Perry Stokes Airport Authority

January 2027
Purpose
Create non-profit entity responsible for airport maintenance, lessee management, and minimum standards enforcement. Common structure at growing regional airports.
Project Description
The Perry Stokes Airport Authority would manage day-to-day airport operations, collect and administer airport fees, and ensure all airport businesses comply with established standards. This governance structure is common at growing regional airports and prepares Perry Stokes for increased commercial activity. The full degree of authority granted will be established in the Authority's charter at the discretion of the Board of County Commissioners.
Benefits
β€’ Funds 1-2 airport maintenance employees
β€’ Reduces BOCC approval burden for routine decisions, such as renewing leases
Who Pays
Pinnacle Jet Centers (charter development)
Cost to County
$0
← Timeline

Main Hangar Construction

Summer 2027
Purpose
Construct 75'x85' insulated hangar capable of holding two light business jets (Challenger 350 class). Currently losing ~1 overnight jet stay per week due to lack of hangar space.
Project Description
Airport utilization is limited by lack of hangar and parking space for larger aircraft. This hangar includes a minimum door height of 21.5' and door width of 65-75'. The parking apron provides concrete parking for three fuel trucks and asphalt apron for two jets, connecting the hangar to the existing taxilane. This hangar will significantly increase airport utilization.
Economic Impact
β€’ 30% increase in jet traffic over 3 years
‒ Double business aviation fuel sales (12K→24K gal/yr)
β€’ ~100 additional monthly tourist visits by 2030
β€’ Est. $768,000/year local economic impact
Who Pays
PJC Cash $250K β€’ PJC Loan $250K β€’ County Grant $300K (requested) β€’ Unmet Need $200K
Note
Hangar reverts to County ownership at end of PJC lease term.
Total Project Cost
$850,000 - $1,000,000
← Timeline

Full Service FBO Equipment

Jan-Jul 2027
Purpose
Acquire equipment needed to service larger and more complex aircraft.
Project Description
Conduct phased purchases and develop training programs for ground support equipment essential to servicing business jets. This equipment enables the airport to provide full-service support comparable to larger regional FBOs, removing service limitations that currently constrain business aviation growth.
Equipment
β€’ Heavy-duty aircraft tug and towbar (14,000-50,000 lbs capacity)
β€’ Lavatory service cart
β€’ Ground Power Units (GPU) with electrical infrastructure
β€’ De-ice cart for winter operations
Who Pays
Pinnacle Jet Centers (Private Investment)
Total Investment
$100,000
← Timeline

Dedicated Hot Refuel Point Installation

2027-2030
Purpose
Safety: Deconflict rotary-wing (helicopter) and fixed-wing traffic. Current hot refuel operations on Taxiway A3 create disruption and wake turbulence hazards.

Capacity: Double fuel throughput for large helicopter flights (4+ aircraft).
Project Description
The only safe place to conduct hot refuels is currently on Taxiway A3. With high daily volume of fixed-wing training traffic, helicopters face challenges accessing the hot refuel point. Dedicated helipads allow complete deconfliction of rotary and fixed-wing traffic. The project includes two concrete helipads capable of accommodating a V-22 Osprey, with asphalt connectors and partial taxiway segment. Each helipad includes a skid-mounted hose reel and fuel truck parking spot. The helipads are "terped" for low-level landing providing deconfliction from fixed-wing traffic.
Who Pays
Primary: Defense Community Infrastructure Grant (DCIP)
Backup: FAA/CDOT Discretionary Funds
Local Match: Up to 5%
Timeline
Schedule A (North Pad): 2027-2028
Schedule B (South Pad): 2028-2029
Schedule C (Optional Taxiway): 2029-2030
Total Project Cost (DCIP)
Up to $2,466,845
← Timeline

Hot Refuel Point Design

Blue = Schedule A (North Pad) β€’ Yellow = Schedule B (South Pad + Taxiway) β€’ Red = Schedule C (Optional)

Hot Refuel Point Layout Diagram
← Back to Timeline

2028-2029 Projects

Private Hangar Development

2028-2029
Purpose
Facilitate private hangar construction on new ground lease plots created by 2026 taxilane project. Up to 6-12 privately owned hangars by 2035.
Project Description
Airport growth is constrained by hangar availability, especially in a location with unpredictable and destructive weather. Private developers will build and own their hangars on County-leased land, creating sustainable revenue for the County while expanding airport capacity. The Airport Layout Plan (ALP) shows potential for 6-12 privately owned 60'x60' (or similar sized) hangars. PJC will assist in finding creative funding solutions for interested hangar developers.
Who Pays
Private Developers (ground leases to County)
Revenue to County
$100-300/month per hangar (based on size)
Private Investment Potential
$400,000 - $1,200,000
← Timeline

AVGAS Fuel Truck

2028
Purpose
Dedicated AVGAS (piston aircraft fuel) truck to improve service for general aviation while Jet-A trucks service military and business aircraft.
Project Description
With growing military and business aviation fuel demands requiring Jet-A trucks, a separate AVGAS truck ensures general aviation pilots receive prompt fueling service without waiting for Jet-A operations to complete. This improves customer experience and supports the projected growth in general aviation operations from 7,582 (2025) to over 9,000 (2030).
Who Pays
Pinnacle Jet Centers
Total Investment
TBD
← Timeline

DLA & CAA Fuel Contracts

2028
Purpose
Secure Defense Logistics Agency (DLA) and Corporate Aviation Association (CAA) fuel contracts to expand the airport's customer base. A DLA contract allows government and military aircraft to purchase fuel using government credit cards at pre-negotiated rates, increasing military utilization beyond the 4th Combat Aviation Brigade. CAA membership provides access to corporate flight departments seeking fuel discounts, expanding business aviation traffic.
Who Pays
Pinnacle Jet Centers (Administrative)
Total Investment
Administrative Only
← Timeline

Parking Lot Repairs

2028
Purpose
Phased repairs to airport parking lot to support increased traffic from hangar development and events.
Project Description
The airport parking lot has deteriorated significantly and requires phased repairs. Repairs will be prioritized based on budget availability and coordinated with other pavement projects to maximize cost efficiency. Improved parking supports the projected increase in passenger enplanements from 624 (2025) to 936 (2030) and accommodates larger events like the 90th Anniversary celebration.
Who Pays
Pinnacle Jet Centers
Total Investment
TBD
← Timeline

Airport Layout Plan - Future Hangar Development Areas

Green areas indicate planned private hangar development zones

Airport Layout Plan showing future hangar areas
← Back to Timeline
×
×

Project Title

2025
